Buildertrend
Request a quote
Four questions, then a call with their team.
- Users
- Unlimited
- Reported by reviews
- $339–$1,099/mo
In the order the work happens on a site
Buildertrend pricing and alternatives · Updated
Buildertrend doesn't publish a price. It asks four questions about your business and books a call. Parli's price is on this page, and so is everything it covers.
What it costs
Buildertrend publishes no price; you get one from a quote. These are the per-plan figures third-party reviews report, and Buildertrend confirms none of them.
| Plan | Reported per month | A year at that rate | Published by Buildertrend |
|---|---|---|---|
| Essential | $339–$499 | $4,068–$5,988 | No, quote only |
| Advanced | $499–$799 | $5,988–$9,588 | No, quote only |
| Complete | $829–$1,099 | $9,948–$13,188 | No, quote only |
Only in Parli
Screens from Parli. Tap one to see it full size.
Say it. It writes the task.The task for the silt fence on lot 44, with Confirm and Decline.
Point right at the spotTap their picture to drop a mark both of you see.
Their own PIN. Their own timeA four-digit PIN each, so nobody clocks in for a buddy.

Every machine. Where it is.Fifteen machines, the job each is on, and two flagged for service.
Nothing slips past serviceOverdue and due this week, with Task and Mark complete on each.
Find cover in a tapParli shows who's free, starting with the crew already on that job.
Your company
Count your people. Parli picks the plan and shows the price. Add operators and the bill doesn't move; it only changes when someone new plans the work from a desk.
Parli
$49/mo
Small Business+
Buildertrend
Quote
Unlimited users
Parli prices are monthly, in US dollars. Paying yearly gets 12 months for the price of 10. Buildertrend's pricing page offers 10% off when you pay a year up front.
Feature by feature
Every Parli feature, checked against Buildertrend. What both do comes first, then what only Parli does.
| Feature | Buildertrend | |
|---|---|---|
| Both do 17 | ||
| DashboardToday's work, what's late and who's out, when you open it. | ||

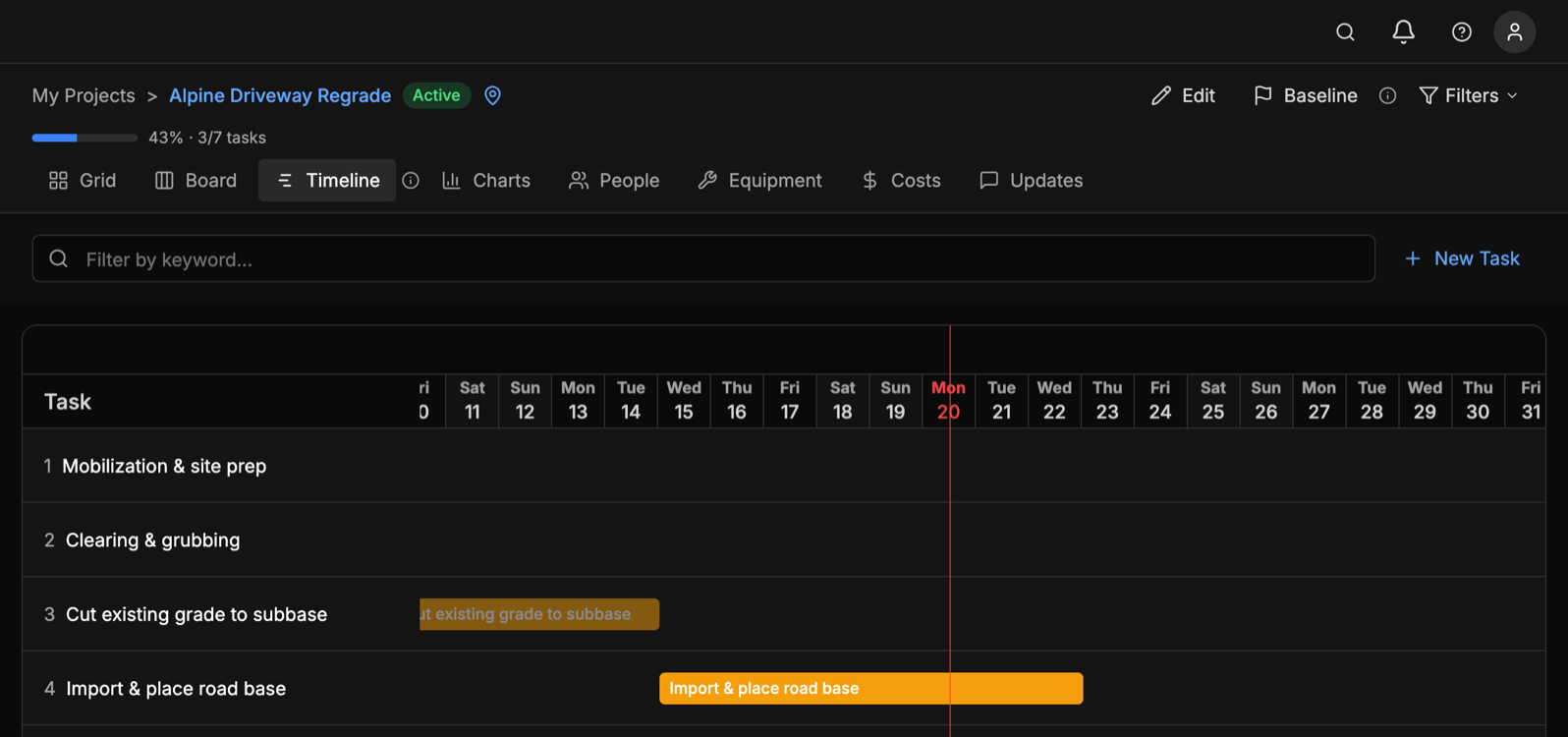

| Scheduling with a Gantt chartDrag a task and the ones linked to it move too. | ||
| CalendarEvery job and task by day, week or month. | ||
| Tasks and checklistsAssigned to a person, checked off from the phone. | ||
| Daily logs with photosCrew, weather, work done and photos, filed from the job. | ||
| Jobsite photos you can mark upDraw on a photo to point out the problem. | ||
| Time clock with job locationsPunches record where they were made. | ||
| Hours to QuickBooks for job costingTime on each job goes into QuickBooks. | ||
| Clock in the whole crew at onceThe foreman checks off who is there. | ||
| Works with no signalClock in and file the day; it sends when there is signal. | ||
| Chat with the crewMessages from the job, kept out of personal texts. | ||
| Subcontractor schedulingEvery visit with its job, days and start time. | ||
| Double-booking warnings for peopleFlagged when someone is booked twice. | ||
| Job costs and reportsBudget, spent and what is left on each job. | ||
| Files and documentsPlans, permits and paperwork, by job. | ||
| Share photos with the clientShow the homeowner the progress. | ||
| iPhone and Android appsAnd the whole thing in a browser. | ||
| Only in Parli 9 | ||
| An AI assistant you can talk toAsk what's behind, or say a task and it writes it. Nothing changes until you tap Confirm. | ||
| Video calls from the jobIt rings like a phone call, opens on the back camera, and you can tap to point at the spot. | ||
| A shop tablet time clockOne tablet on the wall. Each person taps their name and their own PIN. | ||
| Machines booked on the schedulePut a machine, attachment, tool or trailer on a task and it is taken for those dates. | ||
| No machine booked twiceBook one that is already on another job and Parli refuses, and says which job has it. | ||
| Machine service, next to the jobService due shows beside the job it's on and lands on the mechanic's list. | ||
| Out-sick cover in a tapMark someone out and Parli shows who can cover, starting with the crew already on that job. | ||
| The price on the pageNo form and no call to find out what it costs. | ||
| A free planOne job, no card, for as long as you like. | ||
Buildertrend warns you when a person or a sub is booked on two schedule items at once, after you switch that on for each contact. It tracks equipment by tagging it on daily logs, with a GPS pin where the log was made. What it doesn't do is put a machine on the schedule. In Parli a machine is booked like a person: put it on a task and it's taken for those dates, it shows on the board beside the crew, nobody can book it twice, and its service shows up next to the job it's on.
Checked against Buildertrend's own pricing page, help center and announcements, and third-party reviews, on October 18, 2026. Something changed? Email joey@parli.io and we'll fix it.
The whole price list
You pay for office seats: the people who plan the work from a desk. Crew logins are free on every paid plan, and every paid plan holds your whole roster, everyone you schedule, whether or not they sign in. The Free plan holds one person on the roster.
| Plan | Price | Office seats | Extra seats | Crew logins | Jobs at once |
|---|---|---|---|---|---|
| Free | $0/mo | 1 | — | 1 | 1 |
| Small Business+ | $49/mo | 2 | $15 each | Free, no limit | 5 |
| Corporation+ | $99/mo | 3 | $20 each | Free, no limit | Unlimited |
| Enterprise | Custom | Any | Any | Any | Unlimited |
The Free plan holds one person in the office, one in the field and one job, and doesn't include the assistant. Past five office seats, Corporation+ holds up to 30, or Enterprise sizes the seats, storage and assistant use to your company. See everything on each plan →
Which one you want
If you build houses, we'd rather you knew that now than after a demo.
Questions
Buildertrend doesn't publish a price. Its pricing page asks four questions about your business and then books a call to go over a custom quote. Third-party reviews in 2026 estimate about $339 to $1,099 a month across its three plans, but those are other people's numbers. Only a Buildertrend quote is real.
The Free plan is $0. Small Business+ is $49 a month with 2 office seats, and $15 for each one after. Corporation+ is $99 a month with 3 office seats, and $20 for each one after. Enterprise is priced for your company. Crew logins are free on every paid plan, and paying yearly gets 12 months for the price of 10.
An AI assistant you can talk to, video calls from the job, a shop tablet time clock with a PIN for each person, machines booked on the schedule (and refused if they are already on another job), machine service shown next to the job, out-sick cover suggestions, a free plan, and a price on the page.
No. Buildertrend's pricing page offers a custom quote and a call with their team, not a free plan. Parli's Free plan has one job, one person in the office and one in the field, with no card and no time limit.
Yes. Parli has a free plan, and its paid plans are on the page: $49 a month for Small Business+ and $99 for Corporation+, with crew logins free on every paid plan. It's built for dirt work rather than home building, so selections, warranties and change orders aren't in it.
It depends on the work. Buildertrend is built for home builders and remodelers, where client selections, warranties and change orders are the job. For excavation, grading and utilities, where the schedule is people and machines, Parli books the machines on the schedule, clocks in the crew and costs a fraction of the reported price.
No. Its pricing page says unlimited users and unlimited projects, priced by quote. Parli publishes its price instead: you pay for office seats, and everyone in the field signs in free.
Yes. Start on the Free plan with one job, see it against your crew and your machines, and move up when it is worth it. On a paid plan you can bring your machines in from a spreadsheet. The crew gets the iPhone or Android app, and the office uses it in the browser.
Parli is built for dirt work: excavation, grading, utilities, site work and the trades around them. If client selections, warranties and change orders are the heart of your business, Buildertrend is built for that and Parli is not.
Put a job on the schedule and see it against your crew and your machines. No card, and no call.
Sources, checked October 18, 2026. Buildertrend's pricing page (buildertrend.com/pricing) publishes no price, lists unlimited users and unlimited projects, offers 10% off when you pay a year up front, and asks four questions before a call. Its help center describes double-booking alerts for internal users and subs (Advanced Scheduling Overview); direct chat, comments, messages, RFIs and surveys, and no calls (Team Messaging Overview); crew clock-in, geofencing, breaks, overtime and approvals, and no shared tablet (Time Clock Overview); photo and video uploads with annotation (Access Files on Mobile); and daily logs and clock-ins made with no signal (Mobile App FAQs). Its QuickBooks integration page (checked October 22, 2026) describes entering time and expenses for each project for job costing. Its blog post on equipment tracking (updated April 13, 2026) describes daily-log tags and GPS pins. Its September 29, 2026 announcement lists AI Submittals, AI Bill Capture, AI Client Updates and AI Plans, and no assistant. The $339–$1,099 range is from GetOneCrew's Buildertrend pricing review (August 31, 2026), which draws on Downtobid and other 2026 reviews; OneCrew sells competing software, and none of those figures are confirmed by Buildertrend. Parli's prices are per company, per month, in US dollars, from Parli's own price list.
